The slow way to ship a Dynamics 365 security redesign is months of staging and user acceptance testing. We have now taken two very different clients, a smaller US manufacturer and a larger fresh-produce distributor, straight to production without the shipped configuration ever getting its own UAT pass. The surprise is not the go-live day, which in one case took hours, but where the real work and testing happened: weeks earlier, in the data collection. You do not skip the test. You move it earlier, onto real usage.

ℹ If you read one line

Weeks of real production usage test a security redesign better than UAT does, so the build takes days and the go-live hours.

⚠ Watch out

Neither go-live proves that skipping UAT is always safe. One client had been live barely a day when we wrote this. The other never put a user on its new roles, and the structure it put live was later found to have defects that harmed no one only because nobody was assigned to them. The narrower lesson: when the evidence collection is done right, a go-live carries far less risk than people assume, and the remaining risk is known, bounded, and reversible.

The slow way, and why it exists

Most redesigns are staged in a test environment, put through UAT, watched for breakage, and promoted weeks later. That caution is earned: getting security wrong means someone cannot do their job on Monday morning. But a long UAT versus a fast gamble is a false choice when the preparation is right.

What actually took the time, and it was not the go-live

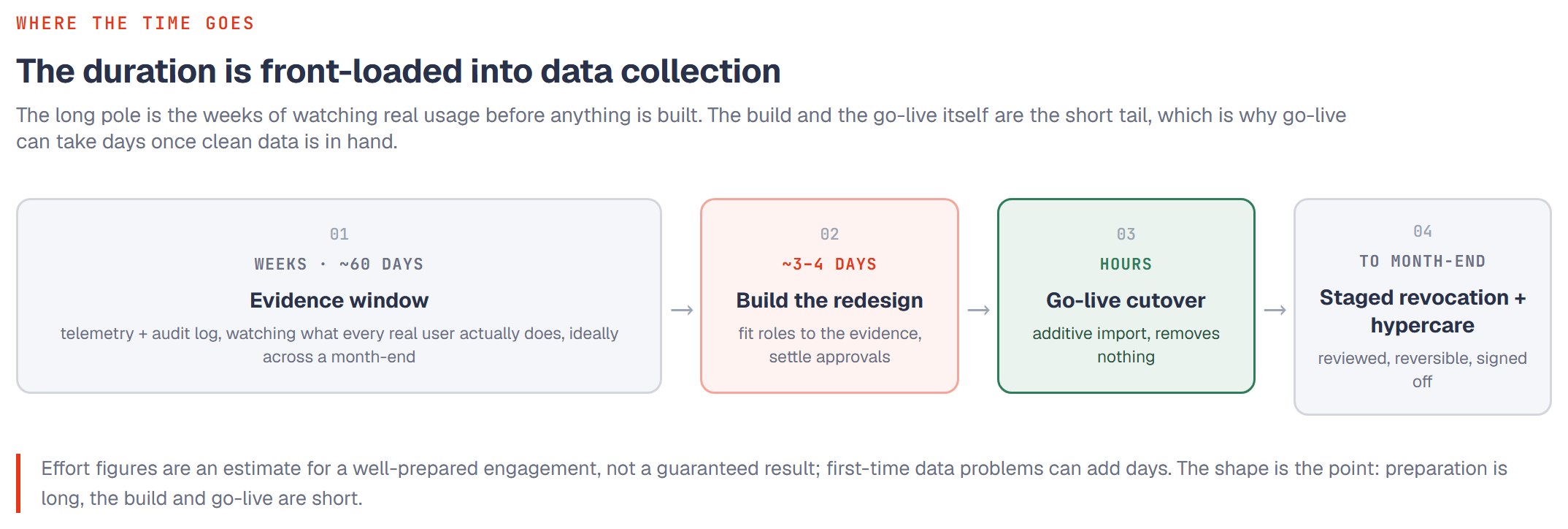

Timeline showing the project duration front-loaded into a roughly sixty-day evidence window of telemetry and audit log, followed by a short three-to-four-day build, an hours-long additive go-live cutover, and staged reversible revocation with hypercare through month-end.

The hands-on build, fitting the roles to the evidence, settling approvals, importing, and checking the result, takes three to four focused person-days once clean data is in hand. The go-live is shorter still: in the measured case, final package to released cutover took hours.

The weeks go into the data collection before that. The evidence window, the stretch over which we watch what people do, is the long pole, and it should be. Our target is around sixty days of usage, including a month-end. That is the real duration of the project, mostly waiting and watching, not building.

These figures are an estimate for a well-prepared next engagement, not a guarantee; first-time data problems have cost days at more than one client. The shape is what matters: the time sits in the preparation; build and go-live are the short tail.

The data collection is the test you are actually running

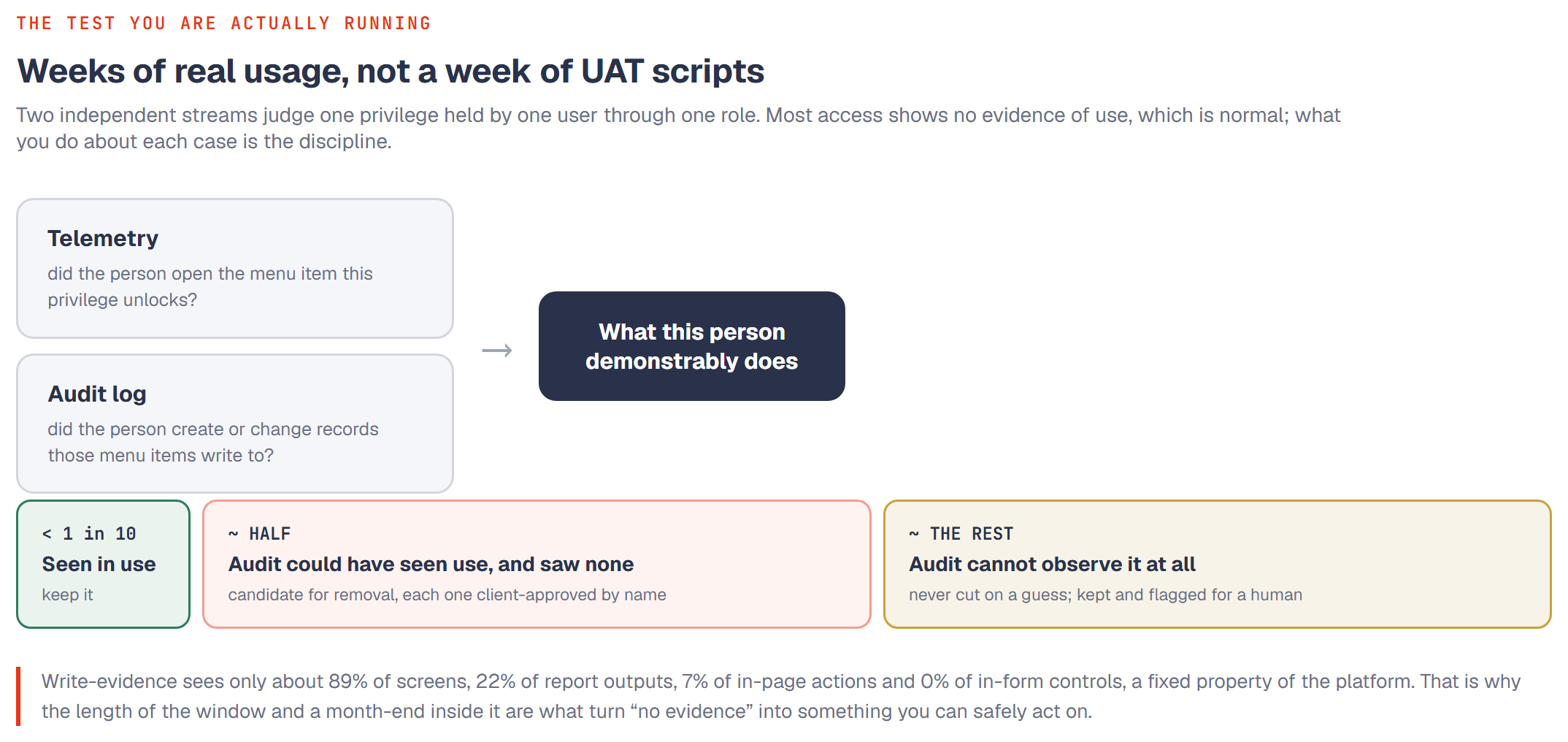

Diagram: telemetry and the audit log feed one record of what each user demonstrably does, splitting every privilege into fewer than one in ten seen in use (keep), about half the audit could have seen and saw nothing (client-approved removal candidate), and the rest the audit cannot observe at all (kept and flagged, never cut on a guess).

A UAT pass has a handful of testers run a handful of scripts for a week and shows what they happened to touch. Weeks of production telemetry and audit history ask every real user, continuously, and show what the whole organization did: a far stronger test of whether a role fits a person, running long before go-live.

The unit of evidence is one privilege, held by one user, through one role. Two independent streams decide whether it is really used:

Two disciplines keep this honest. First, expect more than nine in ten privileges across an estate to come back with no recorded use; that is normal. Second, remove access only where the audit log could have seen use and did not, with the client approving each removal by name. A privilege the audit log cannot observe is never removed on a guess; it is kept and flagged for a human decision. That is why the window's length and its month-end matter so much: they turn "no evidence" into something you can safely act on.

Two estates, same method, two honest outcomes

The same method gave two very different clients two different answers, on purpose. That contrast proves it is disciplined, not optimistic.

A smaller US manufacturerA larger fresh-produce distributor
Business usersFewer than a hundredSeveral hundred
Evidence windowAbout two weeks, no month-endAbout ten days with a gap, no month-end
Go-liveAdditive cutover, then staged revocationAdditive cutover; revocation deliberately held
Cost outcomeA real saving, concentrated in a single roleHeld flat by choice; the window was too thin to cut responsibly
What it showsEvidence can find concentrated, bankable excessDiscipline: do not claim a saving the evidence cannot carry

Neither window reached the sixty-day target with a month-end inside, so at both clients we cut nothing the evidence could not observe and staged every removal behind a sign-off. They show the method's discipline, not a full sixty-day run.

At the manufacturer, the evidence was clear enough to cut over and then remove excess access in separate, signed-off steps. Most of the saving sat in a single role carried by a group of operators, the kind of finding a discount negotiation never surfaces. At the distributor, with a shorter window, a gap, and no month-end, the responsible call was not to cut cost yet. We shipped the cleaner structure, took nothing away, and told the client plainly that claiming any saving needs a longer extraction covering a month-end. Holding a saving we could not yet defend is the method working.

Why the go-live can be bold without being reckless

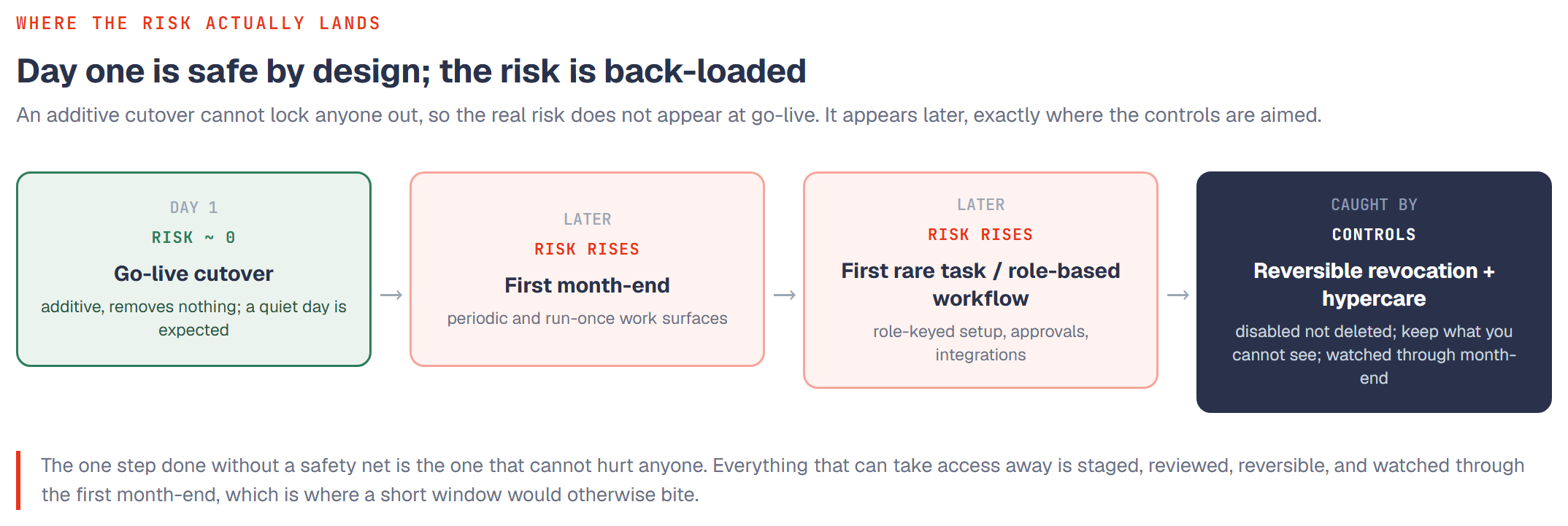

Diagram showing go-live day carrying near-zero risk because the additive cutover removes nothing, with real risk appearing later at the first month-end and the first rare task or role-based workflow, and caught there by reversible revocation and month-end hypercare.

The cutover is additive: it installs the new role structure on top of what people already have and takes nothing away on day one, so it cannot lock anyone out, however good or bad the new structure is. A short list of controls does the rest:

✓ Bottom line

The weeks of evidence collection are the real test. Get them right and the go-live is short and controlled, with the remaining risk back-loaded to the first month-end, the first rare setup task, and the first role-based workflow, exactly where the staged, reversible revocation and hypercare are aimed. Skimp on the preparation and no go-live-day care will save you.

What "done right" actually requires

"Go live in days" is a consequence of preparation, not a shortcut. The preconditions are all about the data:

Do those, and the fast go-live is not a gamble: the one step without a safety net cannot hurt anyone, and everything that can is done slowly, with the evidence in front of you and an undo within reach.

Frequently asked questions

Are you saying companies do not need UAT?

No. By default we would still run, and recommend, UAT on the shipped build. But weeks of real production usage capture most of the testing value earlier and more completely, and an additive cutover built from that evidence lacks the day-one risk people assume. UAT becomes a confirmation step, not the thing the go-live rests on.

How can the build take only a few days?

The slow part, the weeks of evidence collection, happens first. With clean data in hand, the build takes about three to four focused person-days. That is an estimate, not a guarantee; first-time data problems can and do add days.

What if the usage window missed something a person needs?

The design expects that. Nothing the evidence cannot observe is cut on a guess, the cutover removes nothing on day one, and removals are staged, reversible, and watched through a month-end. Anything missed surfaces at the first month-end or rare task, with an undo in reach, instead of locking someone out at go-live.

Did this actually save money?

At one client, yes, concentrated in a single role. At the other, we deliberately held any cost reduction because the evidence window was too thin. Either way, the saving comes from the staged revocation after the cutover, not the cutover itself, and we publish no savings percentage until it is confirmed against the client's actual invoice rather than list prices.
